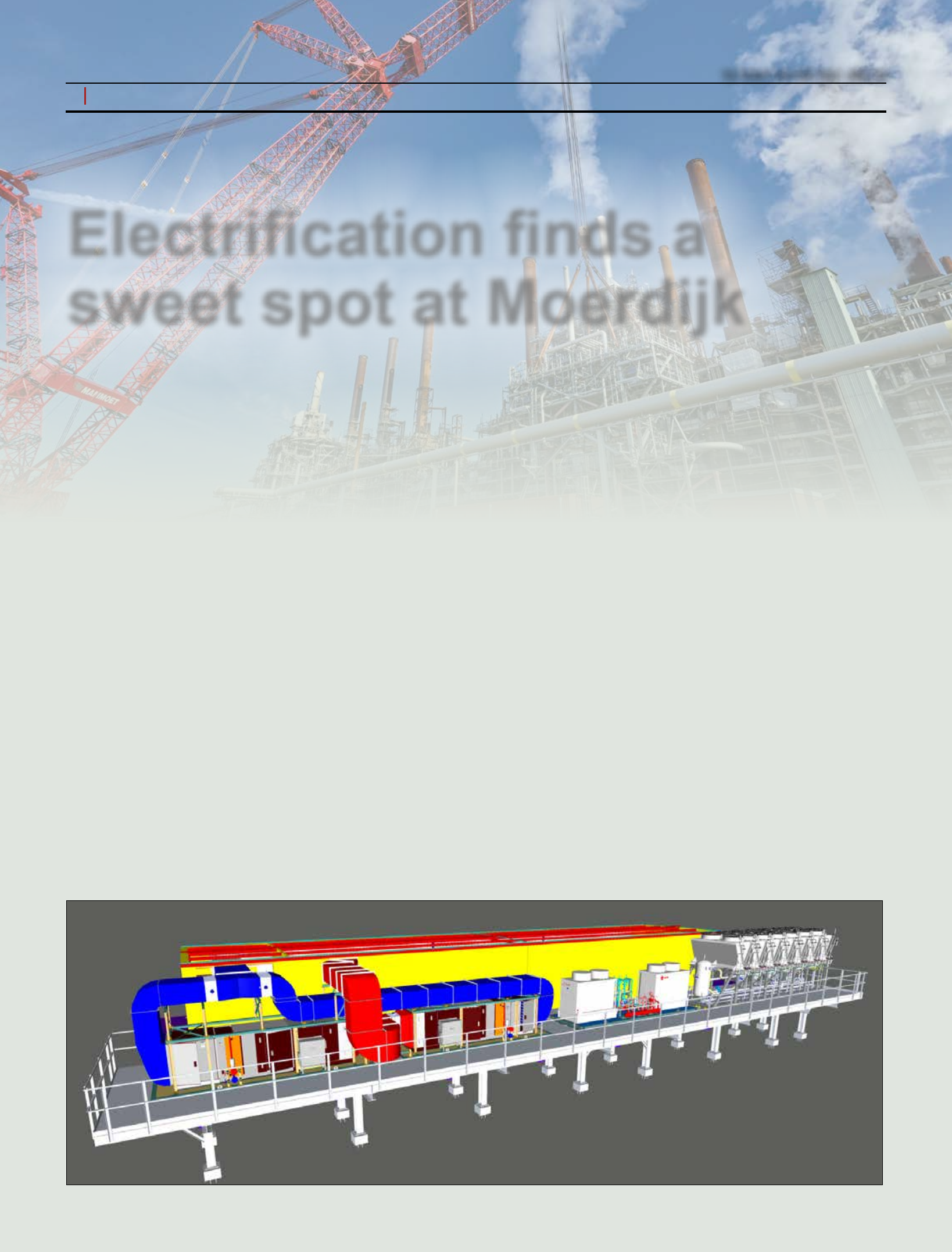

THE ENERGY INDUSTRY TIMES - APRIL 2025
Special Project Supplement
High speed electric motor
with intermediate base frame
connected to the existing
compressor
Shell Chemicals Park
Moerdijk, located in North
Brabant, Netherlands, has
been producing chemicals
since the 1970s. Photo:
courtesy Shell Chemicals Park
Moerdijk
“The second important criterion for
the complete drive system is main-
tainability. If there is a failure, it must
be returned to service very quickly,
within hours. High system efciency
and pro-active monitoring is also very
important.”
As this is a browneld project, it
was paramount that Siemens Energy
paid close attention to space optimisa-
tion.
“The solution must be suitable for
the existing space and foundation.
Usually, the steam turbine has
smaller space requirements than an
electrical drive. So, you need to use
a specially designed high-speed mo-
tor to avoid the need for a gearbox.
We therefore selected products that
both we and Shell are familiar with,”
said Tomic. “It hits the sweet spot in
terms of reliability and sizing.” He
added: “Space also has to be opti-
mised for other areas such as the
substation and transformer.”
Siemens Energy is well positioned
to meet the numerous requirements of
the project. It is one of the largest
suppliers of rotating electric equip-
ment itself, and not only has advanced
tools for equipment design but also
for checking complete system integ-
rity, according to Tomic.
“As a leading company in the eld
of electrical engineering and inte-
grated projects in the power industry
as well as oil and gas, we can provide
complete solutions from high voltage
down to the motor. Siemens Energy is
one of the leading system integrators
for control and automation systems
for these drives,” he said. “Further,
we have a huge database [with data
and experience from similar projects
as well as from compressors and
electrical drives themselves, so we
are able to avoid potential weak
points.”
While this was one key factor in
winning the contract, Siemens Energy
also had to convince Shell that it
could execute it “awlessly”.
Postma explained: “During a turn-
around, when the plant is fully down
the turbine-motor swap will be done
with lots of preparation in advance. It
will be like open-heart surgery where
you have to do everything in time. So,
when the plant is shut down, together
with our partners, we must remove
the existing equipment and replace it
with the new equipment during this
period. So, it all must be perfectly
planned before we execute. This
means you have to put a lot of effort
into investigating and engineering so
that everything is done correctly.”
To ensure it is all completed in this
turnaround window, a number of ac-
tivities will be carried out in advance.
Initially it was planned that both
compression trains would be replaced
at the same time, but it was then de-
cided that the smaller train will be
replaced rst.
“As the smaller train is less critical
it is possible to continue production,
but just at a lower rate,” said Postma.
“If you switch off the smaller com-
pressor, you will just turn down the
total production volume. This means
the smaller train can be done without
stopping the entire process. So, it’s
like a pre-turnaround activity. And
the advantage of this is that we can
learn lessons to improve the second,
most important one that needs to be
done in the turnaround period. We
have experience with this, but every
project has its own characteristics.”
“Everything we can do pre-turn-
around, such as installation of certain
equipment, we will do pre-turn-
around,” added Zuyderduyn. “The
turnaround then includes decommis-
sioning the old steam turbine, remov-
ing it, installing the electrical motor
and connecting it to the compressor.”
The trickiest part will be the rst
startup. “You have to make sure ev-
erything is right”, says Zuyderduyn.
Everything has to be double-checked
and thought through in advance.
Siemens Energy is currently nalis-
ing the engineering. Zuyderduyn
commented: “We are focusing on the
production [of the equipment]. Then
for the middle of this year we will
start rst installations on site. And
then early 2026 is the big turnaround.”
This called for equipment to be or-
dered at an early stage, so that all
equipment is scheduled for delivery
this year. “It is our key focus that
these deliveries do not slip,” said
Zuyderduyn.
Although there will be several
milestones along the way, the key
dates are those for the turnaround –
early 2026 for the smaller 8 MW
compressor train, and a few months
later for the main 25 MW train.
On completion, the Moerdijk proj-
ect will provide a number of addi-
tional benets to Shell, in addition to
environmental and cost reduction.
Firstly, greater digitalisation will be
possible since all systems will be
electronic. “There is a goal to have
data analytics across the entire sys-
tem, so we can analyse the availabil-
ity,” said Postma. “With mechanical
drives, that’s not possible.”
“We are working on solutions to
predict and see degradation of elec-
tronics and then turn that into a pre-
diction of availability or the right
moment to replace it,” said Postma.
He also noted that greater digitalisa-
tion reduces costs.
As decarbonisation efforts continue,
Siemens Energy expects to see more
electrication projects within the
petrochemicals and oil and gas sec-
tors, especially in Europe. “Gas mol-
ecules will be replaced with green
electrons from renewables. And the
faster you can do this, the sooner you
will have sustainable productions,”
said Postma. “There are several pro-
cesses that can’t be electried, and
there you will use hydrogen. But to-
day, this electrication is the sweet
spot for CO
2
reduction.”
Accordingly, Siemens Energy is
gearing up for the surge in electri-
cation. “You see this in our compe-
tence centre, with new people joining
every month,” said Zuyderduyn.
Looking to the future, Postma
summed up: “There is a market here.
Customers are switching from gas to
electricity, which means they need
solutions like this. It’s a huge invest-
ment for Shell but the payback time is
only a few years. Sustainable solu-
tions cost money, but they pay-off in
the long run. This is a protable, sus-
tainable solution.”
cooling systems. The drives are
therefore equipped with totally re-
dundant cooling systems. All the
control systems that control the cool-
ing systems and drives are also con-
gured to be fault tolerant.
The RAM studies also demonstrate
how the solution will be implemented.
“Now the project still has to be deliv-
ered… the proof is in the pudding,”
said Postma.
Mitar Tomic, who is working as
Solutions Architect at Siemens Ener-
gy’s Centre of Competence for E-
Drives, has been involved since the
bidding stage, specifying the solu-
tions and technical scope of the offer.
He said: “We studied their situation
and made sure that the solution is reli-
able. We did a lot of work in selecting
equipment and assessing the various
solutions to translate that into avail-
ability gures; and then demonstrate
that it will work.”
Tomic added: “Unlike other indus-
tries, such as steel or mining, where
you have the opportunity to stop the
process every month or six months,
petrochemicals plants must run
continuously because any unplanned
shutdown results in production
losses and therefore nancial losses.
So, the key requirements for the
electric drive system are reliability
and availability.
9
